How to Build an App Like Procore (Construction Management)
Building a custom construction management platform like Procore costs $120,000–$200,000 and takes 20–24 weeks. The two hardest components are drawing markup with version management and offline-capable mobile with conflict resolution. Specialty subcontractors, companies spending $50,000+/year on Procore and using fewer than 3 of 10 modules, and vertical SaaS startups targeting a construction niche are the primary candidates to build a custom solution.
Key Takeaways
- Custom Procore-like construction platform costs $120,000–$200,000 and takes 20–24 weeks. Build the modules in order: directory and documents first, then RFIs, then drawings.
- Drawing markup is the hardest module. Coordinate-based annotations must survive PDF re-uploads, page re-numbering, and version diffs. This is not a standard document editor problem.
- Offline mobile is required on every construction site. The app must queue actions locally in SQLite, sync on reconnect, and resolve conflicts when multiple users edited the same record offline.
- Procore charges $375–$899 per user per year. A 50-person team pays $18,750–$44,950 per year. A 200-person team pays over $100,000 per year. The build math gets interesting at that scale.
- Build when you are a specialty subcontractor whose workflows do not map to Procore's GC-first model, spending $50,000+/year on Procore while using fewer than 3 of 10 modules, or building vertical SaaS for a construction niche.
Procore charges $375 to $899 per user per year depending on the plan and modules selected. A 50-person team pays $18,750 to $44,950 per year. A 200-person team crosses $100,000 per year. At that price point, Procore is also designed for general contractors running large, multi-phase projects. Specialty subcontractors, owner-operators, and vertical SaaS companies targeting a specific construction niche often find they are paying for 10 modules and using 2.
This article covers what it actually takes to build a construction management platform like Procore, which modules to build first, where the complexity is greater than it looks, and when the build decision makes financial sense.
TL;DR
The short answer: A custom Procore-like construction management platform costs $120,000–$200,000 and takes 20–24 weeks.
| Module | What it covers | Build order |
|---|---|---|
| Project directory and document management | Contacts, roles, file storage, document versions | 1st |
| RFI workflow | Request, response, official answer, status tracking | 2nd |
| Drawing management | Upload, markup, version comparison | 3rd |
| Daily reports | Field logs, weather, labor, equipment, events | 4th |
| Punch list | Deficiency tracking, assignments, photo evidence | 5th |
| Submittals | Submittal log, reviewer routing, approval tracking | 6th |
| Budget and cost management | Budget line items, committed costs, change orders | 7th |
Drawing management and offline mobile sync are the two modules that consistently take longer and cost more than initial estimates.
What a Procore-like platform actually means to build
Procore is seven products connected through a shared project record. The project sits at the center. Every module (RFIs, drawings, submittals, budget) references the same project, the same directory of people, and the same document storage layer.
The project directory is the foundation. Every person on a project has a role: project manager, superintendent, architect, engineer, specialty subcontractor, owner representative. Permissions flow from roles. An electrical subcontractor can view and create RFIs but cannot approve them. A project manager can approve RFIs and access the budget. A subcontractor's foreman can submit daily reports but cannot see committed costs.
Document management sits above the directory. Every project generates hundreds of files: drawings, specifications, submittals, RFI responses, change orders, photos, daily reports. The system needs folder structure, version control, permission-aware sharing, and a reliable large-file upload pipeline. S3 handles storage. The database tracks metadata, version history, and access logs.
The workflow modules (RFIs, submittals, punch list) are routing engines. An RFI is a question from the field to the design team. It needs a creation form, a routing path (who sees it, who must respond, who gives the official answer), a status machine (draft, open, answered, closed), and a notification layer. Submittals follow the same pattern with more routing steps.
Drawing management is the module that separates construction platforms from generic document tools. Drawings are not just PDFs. They are versioned, annotated, compared side by side, and referenced by RFIs and punch list items. The annotation layer is coordinate-based. Every markup item must survive a drawing re-upload.
AI is starting to augment these workflows, but the underlying platform must be solid before automation layers add value. RFI prediction, automated punch list generation from inspection photos, and anomaly detection in daily reports all require clean, structured project data to work from.
Core modules to build (in order)
Module 1: Project directory and document management
Start here. Every other module depends on the directory for people and the document layer for files.
The project directory stores company records, contact records, and role assignments per project. A contact can be on multiple projects with different roles on each. The data model uses three tables: companies, contacts, and project memberships. Project memberships join contacts to projects with a role and a permission set.
Document management needs a folder structure, version tracking, and a large-file upload pipeline. Multipart upload to S3 handles files above 5MB without timeout risk. Each file gets a UUID-keyed S3 path. The database stores the display name, folder path, uploader, upload timestamp, and version number. Version 2 of a drawing does not replace version 1. It creates a new record linked to the same document ID. Both versions stay available.
Permission checking on document access is the part most teams underscope. A document's visibility depends on the requesting user's role on the project, the folder's permission settings, and whether the document is a drawing (which has its own access model). A single permission middleware layer on the API handles this consistently if designed early. Bolting it on later requires a rewrite.
Module 2: RFI workflow

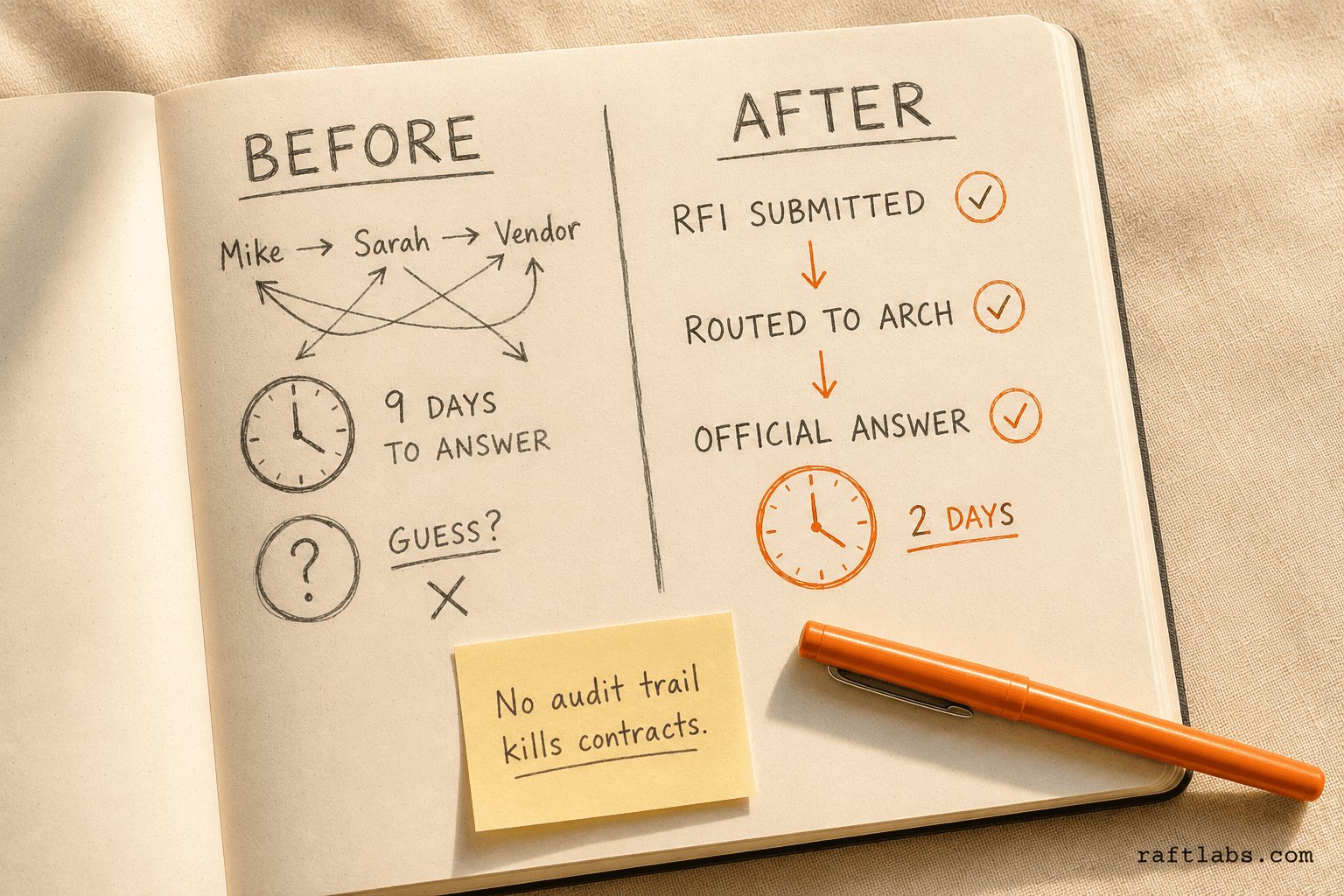

RFIs are the highest-volume workflow item on most construction projects. A complex commercial project generates 200 to 500 RFIs over its lifetime. Each one needs a creation form, a routing path, a response mechanism, and a resolution record.
The RFI data model has five status states: draft, open, in review, answered, and closed. Transitions between states trigger notifications. When an RFI moves from draft to open, the assigned reviewer receives an email and a push notification. When it moves from in review to answered, the ball field worker who submitted it gets notified.
Each RFI stores the question, the ball-in-court assignment (who is responsible for the next action), the due date, the official answer when resolved, and a threaded comment log. Attachments (photos, sketches, reference documents) link to the document storage layer.
RFI numbering follows a project-specific sequence. The 47th RFI on a project is RFI-047. This sequence must be gapless and collision-free in a system where multiple project managers might submit RFIs simultaneously. A database sequence or a row-level lock on the RFI counter handles this.
Module 3: Drawing management
Drawing management is the most technically demanding module. It covers PDF upload, tile-based rendering for large drawings, coordinate-based annotation, and version management with side-by-side comparison.
PDF upload and processing starts with the drawing arriving as a PDF. Construction drawings are large files, often 10 to 50MB each, with multiple pages. On upload, the server extracts page metadata (dimensions, rotation) and creates a drawing record. The page dimensions are critical: every annotation stores its position as a fraction of the page width and height, not as pixel coordinates.
Tile-based rendering is required for large drawings. A 36-inch by 24-inch construction drawing at 150 DPI is a 5,400 by 3,600 pixel image. Rendering the full image for a web browser is slow. The standard approach pre-renders the drawing at multiple zoom levels as a grid of 256-pixel tiles, stored in S3. The frontend loads only the tiles currently visible in the viewport, like a map interface. Apryse (formerly PDFTron) handles this pipeline as a hosted service or a self-hosted SDK. Building a custom tile renderer from scratch is months of work and is not recommended.
Coordinate-based annotation stores every markup item as a data record, not as a baked-in image layer. A markup record contains the annotation type (cloud, arrow, text, dimension, stamp), the page number, the x/y coordinates as page-fraction values, the annotation content (text, color, status), the creator, and the timestamp. The annotations render over the tile layer in the frontend. They are separate from the PDF.
This separation matters for version management. When drawing revision B2 replaces B1, the annotations from B1 carry forward to B2 if the page dimensions match. The system compares page dimensions between versions. If they match, annotations transfer. If the dimensions changed (the drawing was re-scaled), the system flags the annotations as requiring manual review. RFIs linked to the B1 drawing update their reference to B2 automatically.
Version comparison shows B1 and B2 side by side with difference highlighting. The difference layer uses a pixel-diff algorithm on the tile images, highlighting changed regions in a contrasting overlay. This is a display feature, not a structural one. The underlying drawing records are separate. The display layer composites them.
Module 4: Daily reports
Daily reports capture what happened on the job site each day: weather conditions, crew headcount by trade, equipment on site, work completed, issues and delays, and photos. They are the primary field communication record and are often required for contract compliance and insurance claims.
The daily report form is a mobile-first form. Field workers fill it out on-site, often with intermittent connectivity. The form includes structured fields (date, weather from an API, crew count by trade) and free-text narrative fields (work performed, issues encountered, visitors). Photos attach directly from the device camera.
Weather auto-population reduces friction. The app fetches weather data from a weather API using the project's GPS coordinates and populates the temperature and conditions fields automatically. The field worker confirms or overrides.
The report goes through a review and approval workflow. The superintendent approves field reports. The project manager sees approved reports in a daily log timeline. The system generates a monthly PDF digest for owner reports.
Module 5: Punch list
The punch list tracks deficiencies: items that need correction before project closeout. An inspector walks the site, identifies a problem (cracked tile in unit 14B, missing outlet cover in corridor 3), creates a punch list item with a photo, assigns it to the responsible subcontractor, sets a due date, and tracks resolution.
Each punch list item has a location (building, floor, room, or GPS pin), a description, photos, an assigned party, a status (open, in review, resolved, closed), and a resolution record (date resolved, confirming photo). Location is the most important field for large projects. An item assigned to "building A" but without a specific room location wastes a subcontractor's time.
The mobile app must support offline punch list creation. Field inspectors work in areas without signal. They need to create items, attach photos, and assign parties offline. The sync engine queues these operations and resolves them on reconnect.
Module 6: Submittals
Submittals are material and product approvals. Before a subcontractor installs a specific product (a particular brand of HVAC unit, a specific roofing membrane), they submit product data sheets and samples for architect approval. The submittal log tracks what has been submitted, who is reviewing it, and whether it is approved.
The submittal workflow has more routing steps than an RFI. A submittal goes from subcontractor to general contractor to architect to engineer and sometimes to the owner, depending on the spec section. Each reviewer can approve, approve with comments, revise and resubmit, or reject. The revision cycle can repeat multiple times.
The system maintains a submittal log with every revision. Revision 1 through revision N for the same submittal item each get their own record with their own status history. The current revision is the active one. Prior revisions are preserved for the record.
Module 7: Budget and cost management
The budget module tracks original contract value, approved changes, committed costs, and projected final cost per line item. A line item represents a budget category: concrete, framing, electrical rough-in, HVAC, finishes.
Change orders modify the original contract. An owner-initiated scope addition increases the contract value. A subcontractor-initiated change claim adds a pending item. Approved change orders update the committed cost on the relevant line items.
The budget dashboard shows the standard construction cost accounting view: original budget, approved changes, revised budget, committed costs, changes pending approval, projected final cost, and variance from revised budget. This is accounting logic, not just display logic. Every change order must trace back to an original line item.
The tech stack
| Layer | Technology |
|---|---|
| Web frontend | React |
| Mobile (iOS and Android) | React Native |
| API | Node.js |
| Database | PostgreSQL |
| Document and drawing storage | AWS S3 |
| Drawing rendering and annotation | PDF.js or Apryse SDK |
| Offline data layer (mobile) | SQLite with custom sync engine |
| Job queue and caching | Redis |
| Push notifications | Firebase Cloud Messaging |
React Native is required, not optional. Field workers use iPads and Android tablets on job sites. A mobile web app does not provide the offline capabilities or the camera integration quality that native-adjacent code provides.
Apryse (formerly PDFTron) is the recommended choice for drawing rendering if you want to avoid building a tile renderer from scratch. It is a licensed SDK with per-seat pricing, but it covers tile rendering, annotation storage, version comparison, and markup tooling in one package. The alternative is PDF.js for basic rendering and a custom annotation layer built on top, which is workable but adds 3 to 4 weeks of development for drawing markup alone.
How long it takes and what it costs
A full construction management platform runs $120,000–$200,000 over 20–24 weeks.
| Module | Cost estimate | Timeline |
|---|---|---|
| Project directory and document management | $15,000–$25,000 | 3–4 weeks |
| RFI workflow | $12,000–$20,000 | 2–3 weeks |
| Drawing management | $25,000–$45,000 | 4–6 weeks |
| Daily reports | $10,000–$15,000 | 2–3 weeks |
| Punch list | $12,000–$20,000 | 2–3 weeks |
| Submittals | $15,000–$25,000 | 3–4 weeks |
| Budget and cost management | $20,000–$35,000 | 3–4 weeks |
| Offline sync engine | $10,000–$15,000 | 2–3 weeks (cross-module) |
| Total | $120,000–$200,000 | 20–24 weeks |

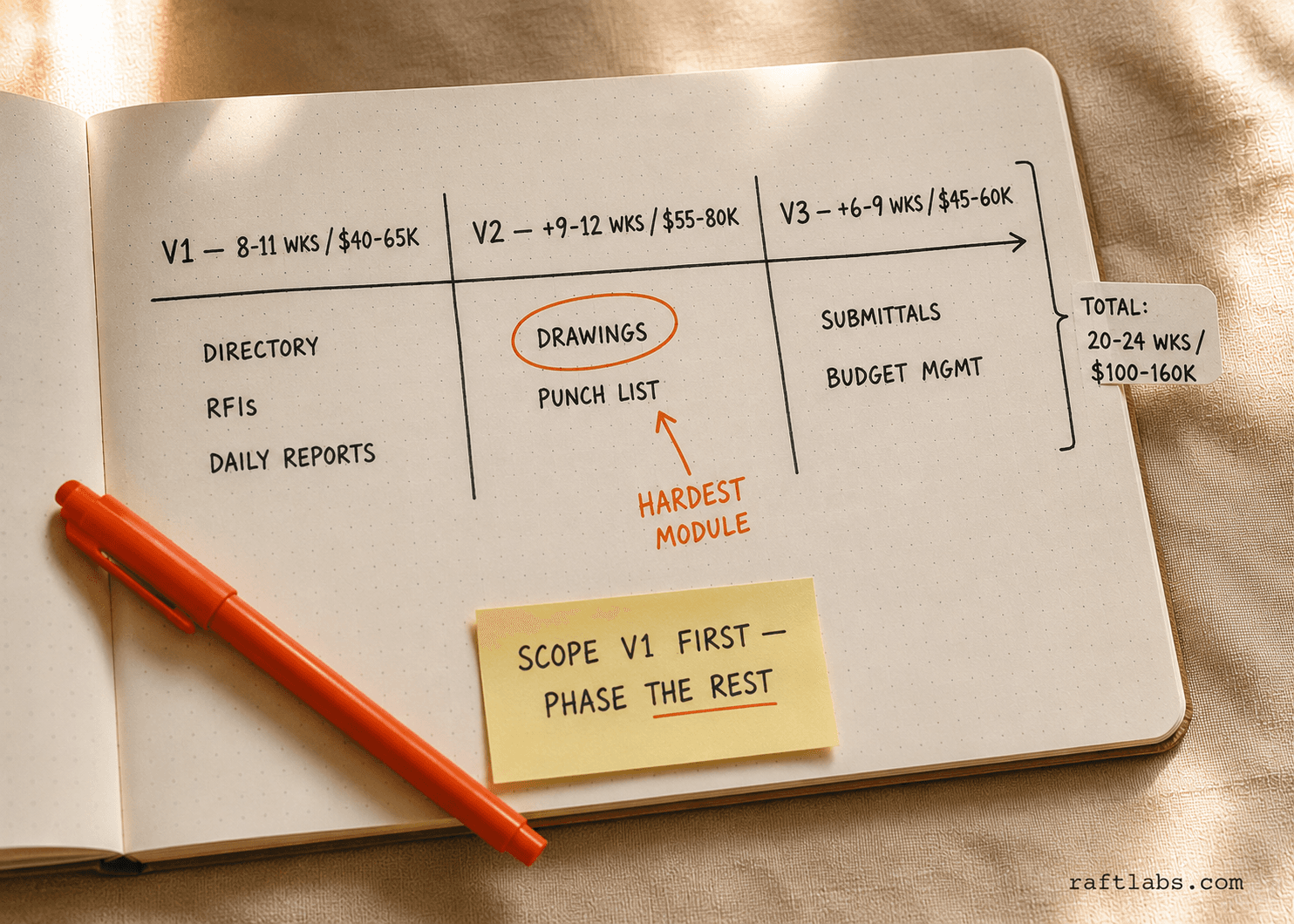

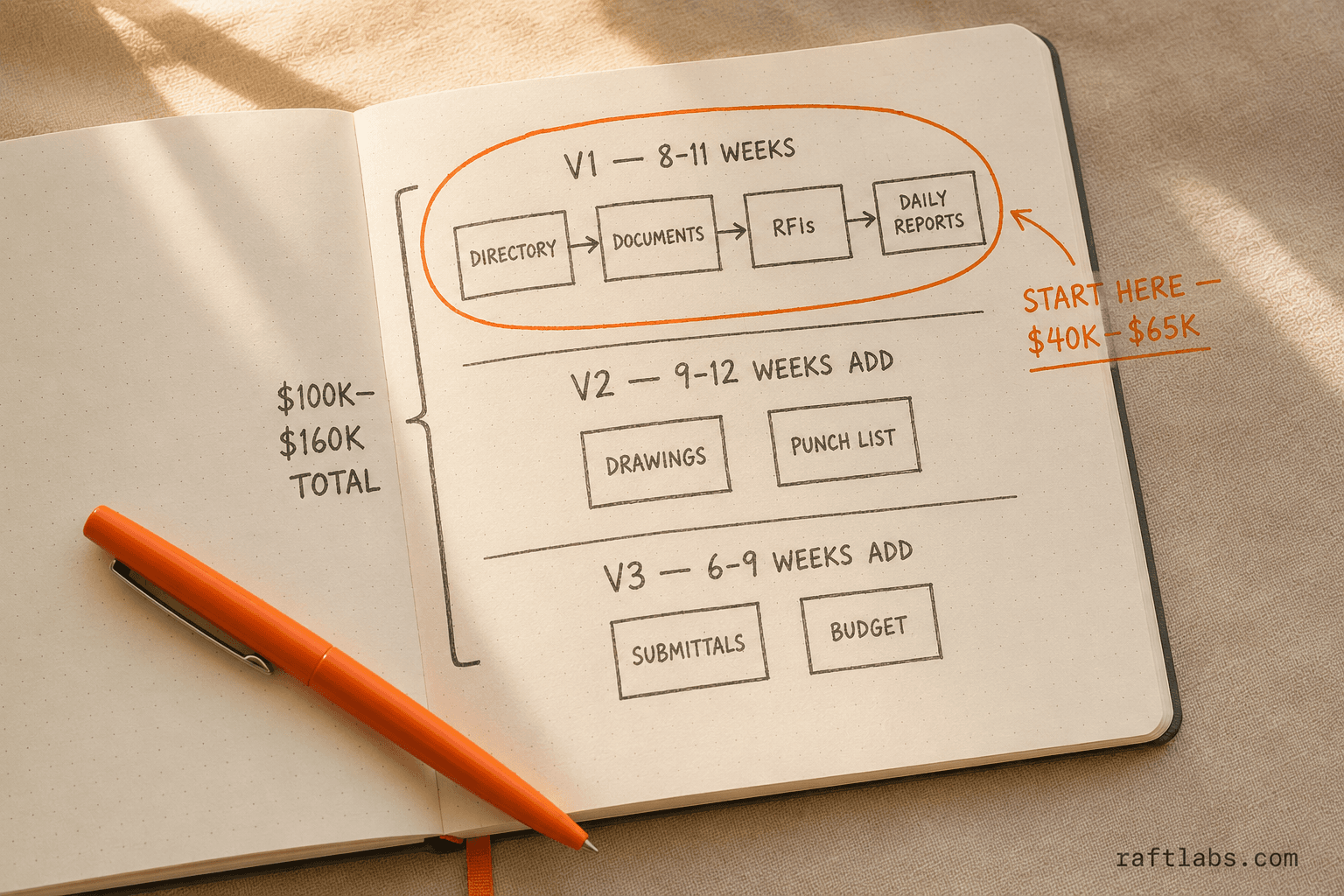

An MVP covering project directory, document management, RFI workflow, and basic daily reports (sufficient for a specialty subcontractor's internal use) runs $40,000–$65,000 over 8–11 weeks.
The two hardest technical problems
Drawing markup and version management
Drawing markup sounds like a document annotation feature. It is not. It is a coordinate-mapping problem that gets harder every time a drawing revision arrives.
Construction drawings go through revision cycles. Drawing A-101 goes from revision 0 to revision 1 to revision 2 as the architect updates the design. Each revision is a new PDF. But all the annotations from previous revisions (RFI bubbles, punch list markers, scope markup from the GC) must carry forward to the new revision if the page geometry matches.

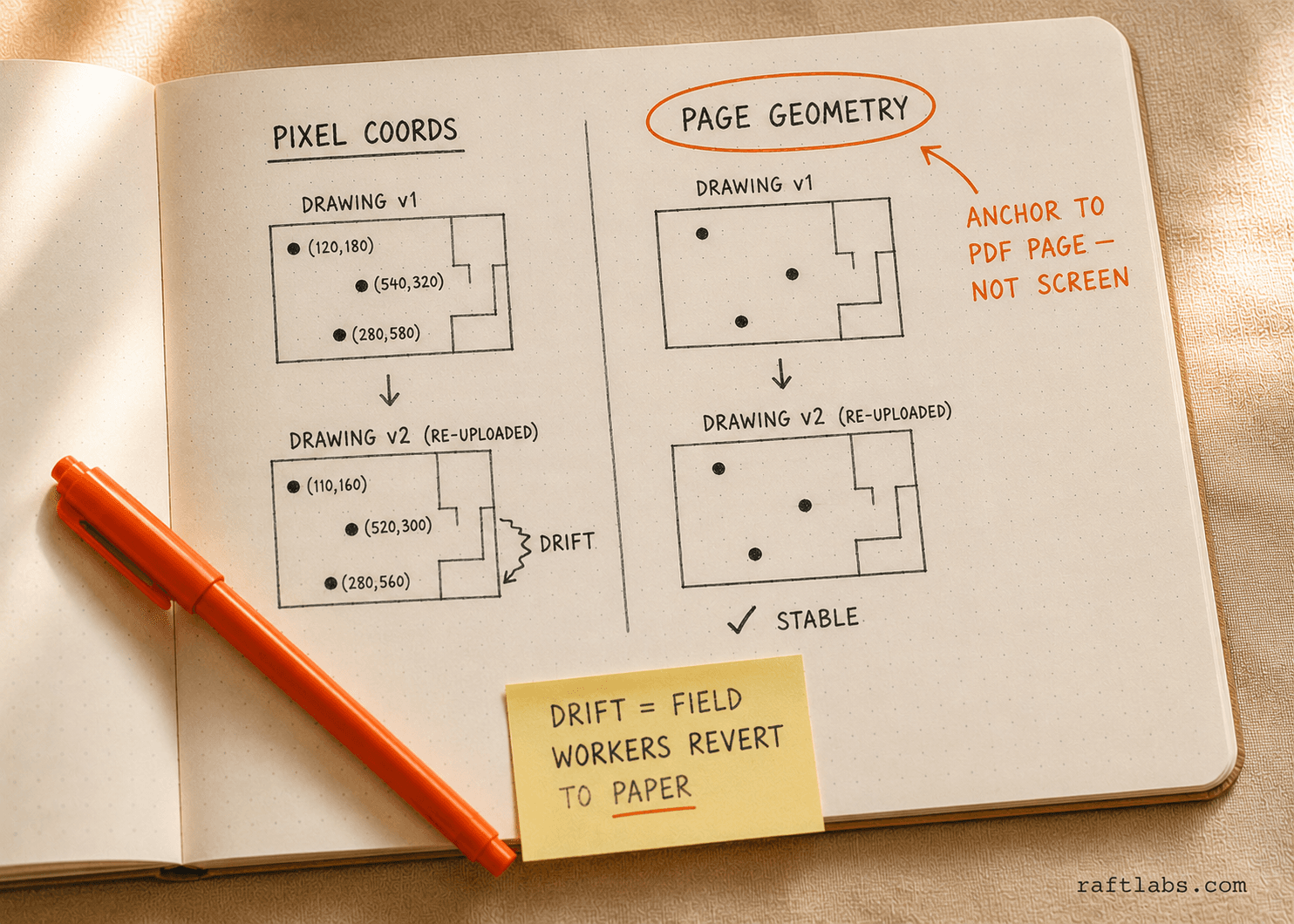

The coordinate system is the key. Every annotation stores its position as a fraction of the page's width and height, not as pixels. If the page is 3,600 pixels wide and an annotation is at pixel 1,800 from the left, it stores as x: 0.5. When the same drawing is re-uploaded at a different resolution, the annotation still renders at 50% from the left because the fractional coordinate is resolution-independent.
Page geometry changes break this. If the architect re-crops the drawing (changing the page dimensions), a 0.5 x-coordinate no longer points to the same physical location on the drawing. The system must detect dimension changes on re-upload, flag affected annotations, and require the project manager to confirm or reposition them.
Version comparison adds tile-level diffing. The frontend fetches tile grids for both versions and runs a pixel comparison at each tile position. Changed tiles render with a yellow overlay. This helps the GC quickly see what the architect changed between revision 1 and revision 2 without studying both drawings manually.
Tile pre-rendering runs as a background job on upload. The pipeline converts the PDF to a series of JPEG tiles at four zoom levels, stores them in S3 under a version-specific prefix, and marks the drawing ready for viewing once processing completes. A webhook notifies the frontend when tiles are ready. The upload-to-viewable time target is under 60 seconds for a standard 10MB drawing.
Offline mobile with conflict resolution
Job sites have unreliable cellular signal. A superintendent completing a daily report inside a partially constructed building, a foreman adding punch list items in a basement parking structure, and an inspector walking a remote industrial site all face the same problem: the app must work with no connection.
The offline layer uses SQLite on device to mirror the data structures that field workers interact with: daily reports, punch list items, RFI status, and recent drawing annotations. On app load with a connection, the app syncs down the current state of all active project data. On app load without a connection, it reads from SQLite.
All write operations go to a local action queue first. An action queue record stores the operation type (create daily report, update punch list item status, add RFI comment), the payload, and a timestamp. The queue worker attempts to sync queued operations to the server whenever connectivity is detected.
Conflict resolution is the hard part. Two field workers can update the same punch list item while offline. Worker A changes the status from open to in review. Worker B adds a photo. When both sync, the server receives two operations that both reference the same punch list item's last-known state.
The resolution strategy uses last-write-wins for status fields (the most recent status update wins) and merge semantics for additive fields like photo attachments and comment threads (both additions are preserved). The server applies these rules deterministically. The client shows a notification when a conflict was detected and resolved automatically, so the user knows to verify the item.
The sync engine also handles bulk operations. When a field worker comes back online after four hours of offline work, they may have 30 queued operations. The sync engine batches these into a single API call, processes them in timestamp order, and returns a conflict report if any required manual resolution.
Build vs. Procore: when custom wins
Procore wins for: general contractors and project owners managing large commercial construction projects. Procore's drawing management, submittal tracking, and financial tools are deep and proven. The $375 to $899 per-user annual cost is justified for teams actively using the major modules. The company has spent 20 years building out compliance, integrations, and edge cases.
Custom wins for:
Specialty subcontractors. Procore was designed for general contractors. An electrical subcontractor's workflows (takeoff tracking, material procurement, labor distribution, inspection logs for electrical rough-in) do not map cleanly to Procore's model. A custom platform built around the electrical trade's actual workflow outperforms a general-purpose tool configured to approximate it.

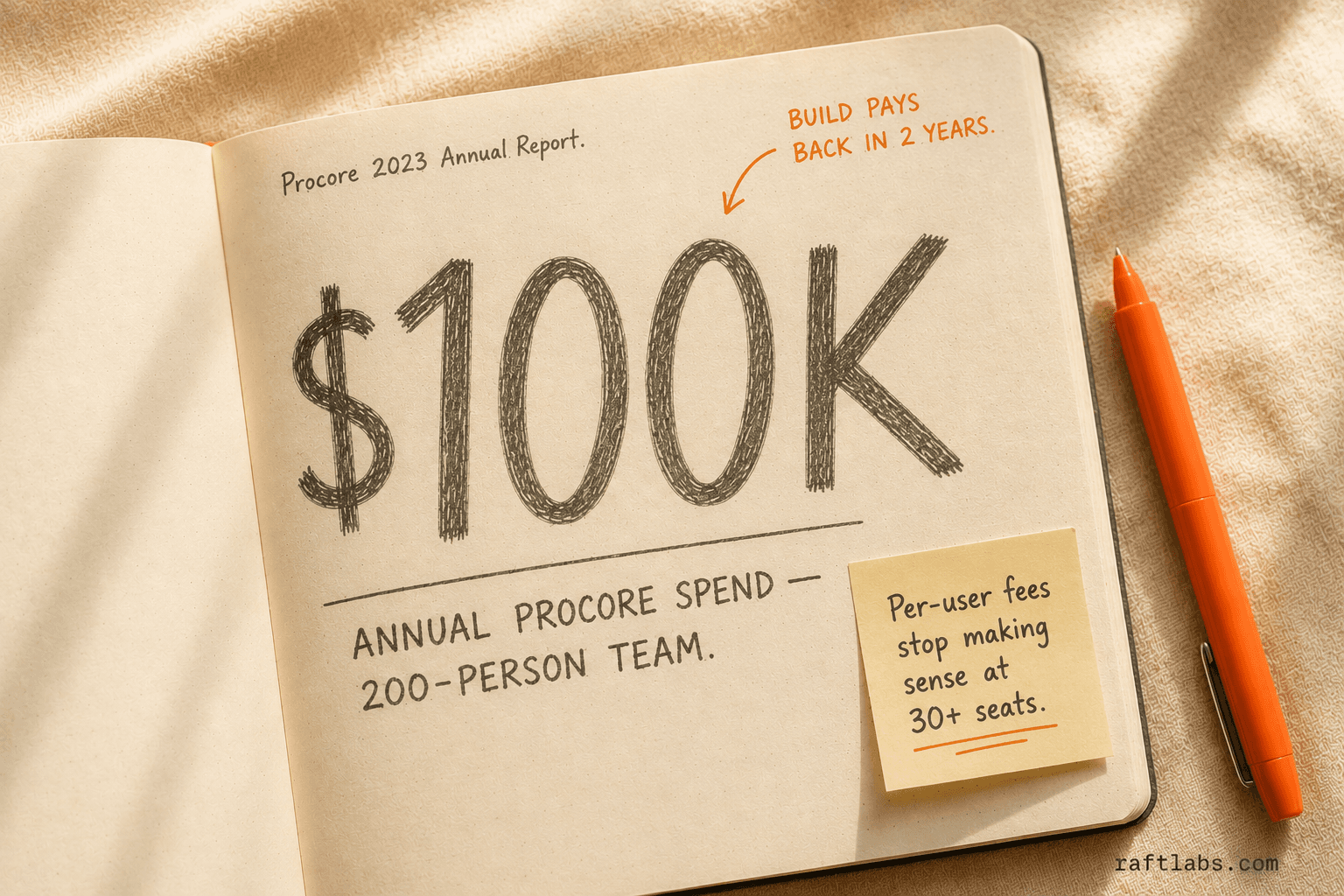

High-spend teams using few modules. A 200-person company paying $100,000 per year for Procore and actively using the directory, daily reports, and punch list (three of ten modules) is a candidate to build. The three modules they use can be replicated for a fraction of the annual cost. The build pays back within 18 months.
Vertical SaaS startups. A startup building software for modular construction companies, for infrastructure inspection contractors, or for residential renovation companies is building a product, not buying a tool. The software is the business. Procore is a competitor, not a foundation.
Owner-operators with fixed-cost needs. A company that manages construction as a department (a real estate developer, a facilities management firm, a government agency) may have 15 project managers who need project tracking, drawing access, and RFIs. Procore charges per user. A custom platform charges nothing after the build. Over five years, the economics look very different.
How RaftLabs can help
RaftLabs has built project management, document workflow, and field operations software for construction-adjacent clients. We know the drawing annotation architecture, the offline sync design pattern, and the places teams consistently underscope: tile rendering performance on large drawings, conflict resolution in the sync engine, and the permission model for multi-party project access.
Our SaaS development process for a construction management MVP (directory, documents, RFIs, and daily reports) runs $40,000–$65,000 over 8–11 weeks. We start with a discovery sprint that maps your trade-specific workflows, your field worker device types, and your integration requirements with estimating, accounting, and ERP systems, then produce a fixed-scope proposal.

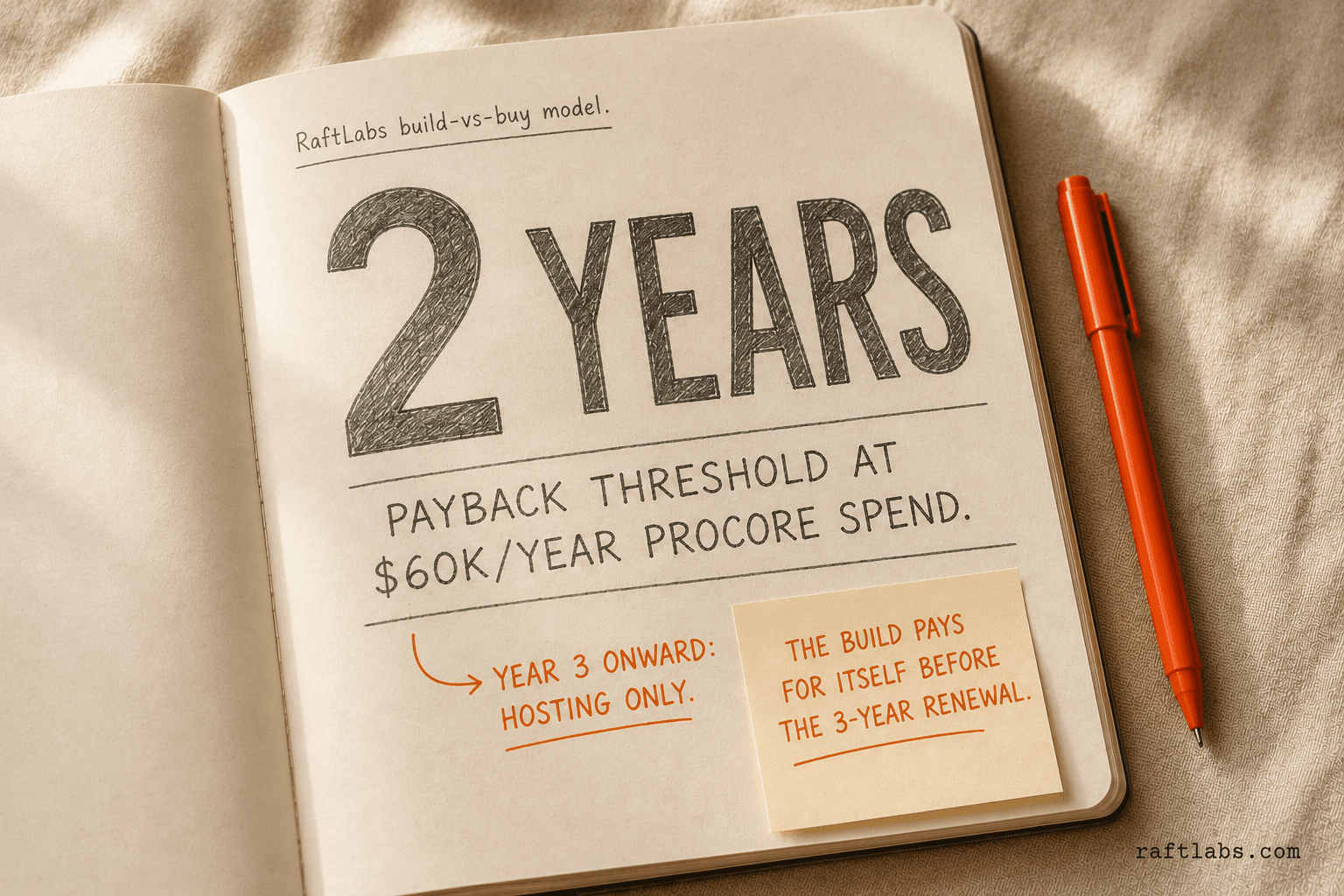

If Procore is a cost center that does not fit how you actually work, the build conversation is worth having before the next renewal.
Frequently asked questions
- A custom construction management platform comparable to Procore costs $120,000–$200,000 and takes 20–24 weeks. The core modules built in priority order are: project directory and document management, RFI workflow, drawing management with markup and versioning, daily reports, punch list, submittals, and budget and cost management. Drawing management and offline mobile are the two most expensive modules to build correctly.
- Two components are genuinely hard. First, drawing markup with version management: annotations are coordinate-based and must survive PDF re-uploads, page re-numbering, and side-by-side version comparison. This requires tile-based rendering and a coordinate system anchored to the PDF page, not the screen. Second, offline mobile: the app must queue all actions locally in SQLite, sync on reconnect, and resolve conflicts when two field workers edited the same daily report or punch list item while offline.
- The standard stack is React for the web frontend, React Native for iOS and Android, Node.js for the API, PostgreSQL for structured project data, AWS S3 for documents and drawing storage, PDF.js or Apryse for drawing rendering and annotation, Redis for caching and job queues, and Firebase Cloud Messaging for push notifications. The offline data layer in React Native uses SQLite with a custom sync engine. Drawing storage requires an additional layer for tile pre-rendering.
- Build when you are a specialty subcontractor whose workflows (electrical, mechanical, concrete) do not fit Procore's general contractor model. Build when you are spending $50,000 or more per year on Procore but actively using fewer than 3 of its 10 modules. Build when you are a vertical SaaS startup targeting a specific construction niche and need software purpose-built for that niche. Any general contractor or project owner managing multiple projects with full teams should use Procore. The depth of Procore's drawing management and submittal tracking is hard to replicate quickly.
- Yes. Field workers on active job sites routinely lose cell signal inside buildings under construction, in basements, and in remote locations. If the app requires a live connection for daily reports, punch list items, or inspection forms, field workers will revert to paper and enter data later, which defeats the purpose. The offline layer must persist all data locally, queue sync operations, and resolve conflicts automatically when connectivity returns.
