LMS Development: Cost, Timeline, and When Custom Beats Moodle
A plain-English guide to custom LMS development for business owners. Covers cost by phase, when Moodle or Canvas stops working, real failure modes, and what a production-ready learning platform actually takes to build.

In this article
Short answer
Custom LMS development costs $25K-$60K for an MVP and $60K-$150K+ for a full-featured platform. Organizations choose custom when Moodle, Canvas, or TalentLMS can not support white-labelling, SCORM reporting, or multi-tenant employee training at scale. RaftLabs ships production-ready LMS platforms in 8-14 weeks.
Key takeaways
- Custom LMS development makes financial sense when per-seat SaaS fees exceed $2K/month or when your workflow requires white-labelling, SCORM compliance, or SSO that off-the-shelf tools do not support.
- An MVP LMS (course builder, video, progress tracking, quiz, certificate) costs $25K-$60K and ships in 8-10 weeks. The biggest variable is video infrastructure complexity.
- Moodle, Canvas, and TalentLMS each have a ceiling: Moodle stalls on UX customization, Canvas on multi-tenant architecture, and TalentLMS on advanced reporting for large enterprises.
- The course builder is consistently underscoped. It carries the most interaction states of any component in the platform and takes 30-50% longer to build than initial estimates.
- Completion rate is the only LMS metric that matters. Instrument it from day one or you have no way to prove the platform is delivering learning outcomes.
Your HR team has been running employee training on TalentLMS for two years. Usage is fine. Completion rates are not. The platform fee has climbed to $3.4K/month as headcount grew, reporting exports require manual cleanup every quarter, and the last enterprise prospect walked when your sales team could not demo an SSO-connected, white-labelled version of the product. You have now asked whether it makes sense to build your own.
That question has a real answer. It depends on three numbers: what you currently pay, how much the missing functionality is costing you in lost deals or manual work, and what a custom platform would actually cost to build. This guide covers all three.
What custom LMS development actually costs
The range you will see quoted online is $20K to $500K. That spread is not useful. Here is what the three real tiers cost, based on what is actually inside each one.

| Tier | What you get | Timeline | Cost |
|---|---|---|---|
| MVP | Course builder, video hosting, progress tracking, quiz, certificate | 8-10 weeks | $25K-$60K |
| Full B2B platform | Team management, SSO, multi-tenant orgs, analytics dashboard | 12-16 weeks | $60K-$100K |
| Enterprise LMS | SCORM compliance, white-labelling, advanced reporting, HRIS integration | 16-22 weeks | $100K-$150K+ |
Primary cost variables:
SCORM compliance: Adds $10K-$20K and three to four weeks. The logic is not complex; the testing surface is large.

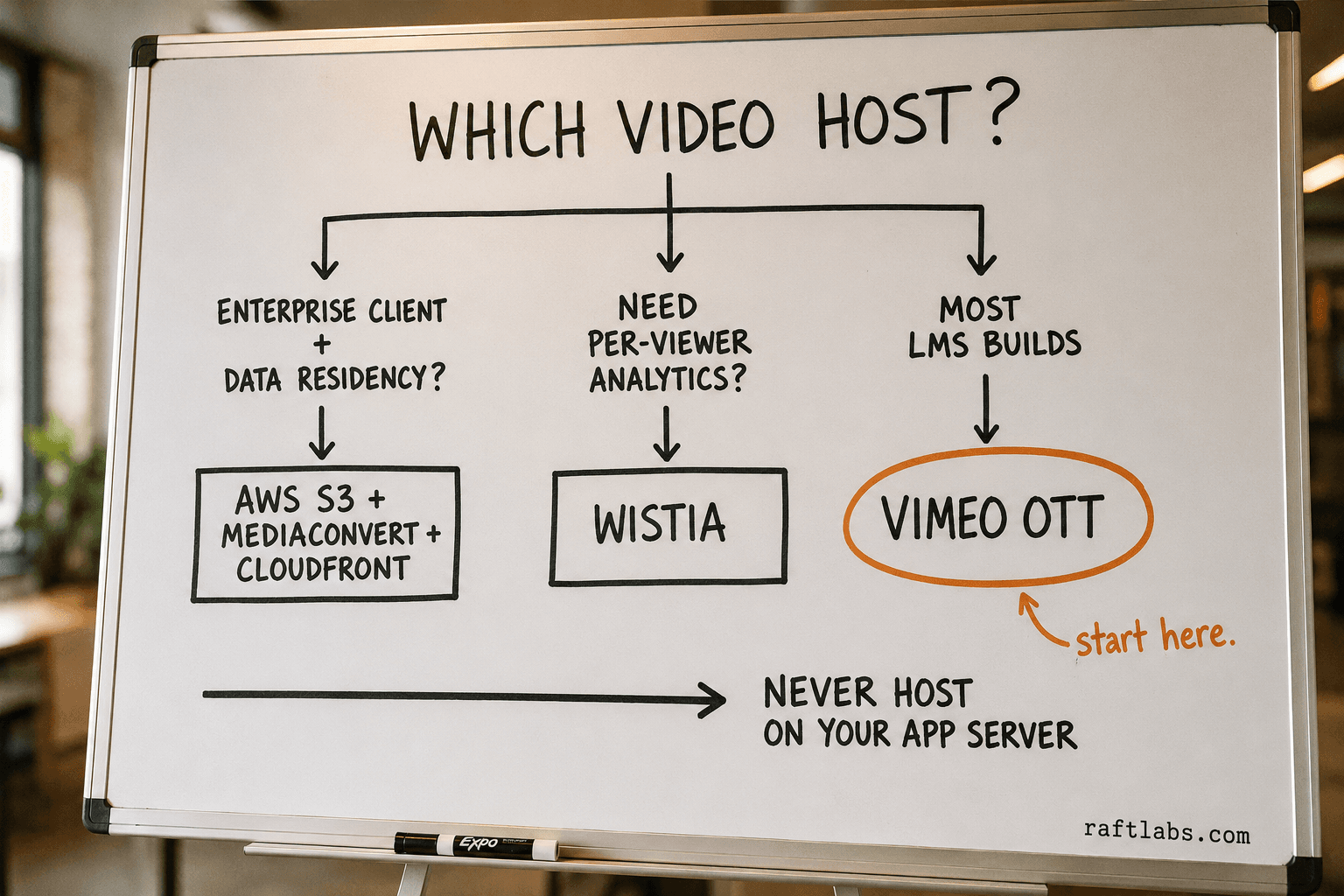

Video infrastructure on AWS vs. Vimeo: AWS (S3 plus MediaConvert plus CloudFront) adds $5K-$15K over a Vimeo integration. Required for enterprise clients with data residency rules.
SSO integration (SAML or OIDC): Adds $5K-$10K. Mandatory for any B2B sale into a mid-size or larger organization.
Mobile apps: iOS and Android add $20K-$40K on top of the web platform.
Gamification layer: Points, badges, and leaderboards add $8K-$15K and two to three weeks. Build this after completion rate data exists.
According to Grand View Research, the global corporate LMS market is projected to surpass $50B by 2030, growing at a CAGR of 23.8% - a rate driven largely by organizations moving off generic SaaS onto platforms built for their specific training workflows.
Moodle, Canvas, and TalentLMS: when each one stops working
These three platforms cover most LMS use cases at a reasonable price. Each has a specific ceiling. Understanding where that ceiling sits tells you whether you have hit it.
Moodle
Moodle is open-source and free to self-host, which makes it attractive to educational institutions and nonprofits running on tight budgets. The ceiling appears when you need visual customization beyond theme tweaks, when your learners expect a consumer-grade mobile experience, or when you need an admin interface that non-technical staff can operate without training. Moodle's interface has not changed conceptually since 2002. For organizations whose learners compare their training experience to Netflix or LinkedIn Learning, Moodle creates friction that shows up in completion rates.
Custom development makes sense over Moodle when: you have already spent money on Moodle consulting to work around UX limitations, when your admin team spends more than four hours per week fighting the interface, or when white-labelling for resale is a product requirement.
Canvas
Canvas (Instructure) is the dominant LMS in higher education. It is well-built and genuinely modern by LMS standards. The ceiling appears in multi-tenant corporate training scenarios. Canvas is architected around courses and enrollments, not around organizational hierarchies, team management, or the kind of seat-based licensing model that corporate L&D teams need. If your training program spans multiple client organizations and each needs their own admin portal, scoped data visibility, and branded experience, you will be fighting Canvas architecture every step of the way.
Custom development makes sense over Canvas when: you are selling training to other organizations (not running it internally), when you need client-branded portals with isolated learner data, or when your pricing model is per-seat per-client rather than per-learner.
TalentLMS
TalentLMS is the most practical general-purpose LMS for corporate training teams up to around 500 learners. It has a clean interface, reasonable reporting, and good mobile apps. The ceiling appears in three places: reporting depth (its built-in analytics do not support the custom metric definitions that large L&D teams need), integration limits (connecting to your HRIS for automated provisioning requires workarounds or third-party middleware), and cost at scale (pricing grows linearly with active users and can hit $3K-$5K/month for large organizations, at which point custom development amortizes within two to three years).
Custom development makes sense over TalentLMS when: your monthly TalentLMS bill exceeds $2K and is growing, when you need real-time HRIS sync for automated learner provisioning, or when compliance reporting requires custom metric definitions the platform does not support.
A 2023 Brandon Hall Group study found that 62% of organizations using off-the-shelf LMS platforms reported moderate to significant limitations in reporting and analytics capabilities - the most-cited reason for evaluating custom development. (Source: Brandon Hall Group, Learning Technology Benchmarking Study, 2023.)
Teachable, Thinkific, and Kajabi: when creator platforms stop working
Moodle, Canvas, and TalentLMS serve institutions and corporate training teams. A different set of platforms serves individual course creators and small education businesses building their own products: Teachable, Thinkific, and Kajabi. They have their own ceiling, and it shows up differently.
Teachable ($39-$299/month plus 5% per transaction on the free plan) is built for creators selling individual courses and memberships. It breaks down when you need a branded mobile app that students install under your name rather than Teachable's, and it has no way to issue SCORM packages or connect to a corporate LRS. A creator doing $500K in annual course revenue pays roughly $25K/year in transaction fees alone, before the subscription cost.
Thinkific ($36-$149/month, no transaction fees on paid plans) removes the per-transaction cost but shares Teachable's ceiling on mobile apps, SSO, and SCORM/LRS integration. Cohort features exist but stay basic.
Kajabi ($119-$399/month) bundles email marketing and a community tool into the platform. The trade-off: creators pay for features they may not use, and the course player itself is less configurable than a dedicated LMS.
Custom development beats all three when: an enterprise or mid-market client requires SAML SSO as a condition of signing (no platform in this price range offers it in a way that satisfies IT procurement), you need a white-labelled mobile app under your own brand rather than a generic shell app, or your revenue has grown enough that annual platform fees now exceed what a custom build would cost to amortize over three to four years.
"The platforms are excellent for solopreneurs and small teams. But the moment a corporate client asks 'does this integrate with our Workday instance,' you need something they built for you," says Ashit Vora, co-founder of RaftLabs.
Who actually builds a custom LMS
Custom LMS development is not the right answer for everyone. It is the right answer for a specific set of operators. Here is what those organizations look like in practice.
Corporate training teams at mid-size companies (200-2K employees). Your training content is proprietary. Your compliance requirements (safety certifications, role-specific onboarding, annual recertification) are specific enough that generic course templates do not work. You need automated provisioning from your HRIS so new hires enter the right training tracks on day one. TalentLMS or Workday Learning covers some of this but not all of it, and the manual admin overhead is real.
B2B SaaS companies building training into their product. You sell software and want to offer structured onboarding and certification to your customers inside your own platform. Embedding a white-labelled LMS under your brand costs less than building one from scratch but more than a raw TalentLMS integration. The business case is clear: customers who complete structured onboarding churn less. According to Gainsight's 2023 Customer Success Index, structured in-product training reduces first-year churn by an average of 18%. Grand View Research confirms the broader trend: the online tutoring and corporate learning services market is growing at 14.5% annually through 2030, with platforms that embed training directly into product workflows capturing the fastest-growing share.
Training companies selling courses to other organizations. You produce compliance training, safety certification, or professional development content and sell it to corporate clients. Those clients have existing LMS platforms (Cornerstone, SAP SuccessFactors, Workday) and may require SCORM-packaged content they can host internally. A custom LMS with a SCORM export layer lets you sell to this segment. Doing it on TalentLMS is not possible; Moodle can do parts of it with significant configuration effort.
Academic institutions building supplementary programs. You run a bootcamp, professional certification program, or executive education course alongside a university's main Canvas or Blackboard installation. You want your program's learner experience to be distinct, not templated. A custom platform lets you own the brand experience end-to-end while integrating with the institution's SSO.
Professional associations issuing continuing education credits. A professional association with a member base of 10K+ issues CEUs or CPE credits for completed courses. Members need certificates their licensing boards accept, which means the LMS must track specific completion criteria and generate compliant documentation - a level of compliance tracking generic platforms do not support. The custom platform also becomes the member benefit that justifies annual dues.
Course creators with an audience large enough to justify a mobile app. A creator with 20K+ students selling courses in the $500-$2K range has built a brand their students recognize. Mobile devices account for the majority of global internet traffic, and creators whose students check progress and watch lessons primarily on mobile are leaving engagement on the table with a generic third-party app shell. A custom iOS and Android app, white-labelled to their brand and submitted under their own App Store account, is both a product upgrade and a competitive moat.
V1, V2, V3: what to build at each phase
The mistake most organizations make in LMS development is scoping everything at once. A platform with gamification, AI tutoring, cohort management, and advanced analytics sounds complete on paper. In practice, you will not know which of those features actually improve completion rates until you have usage data. Build the minimum that works, measure it, then invest in what the data shows matters.

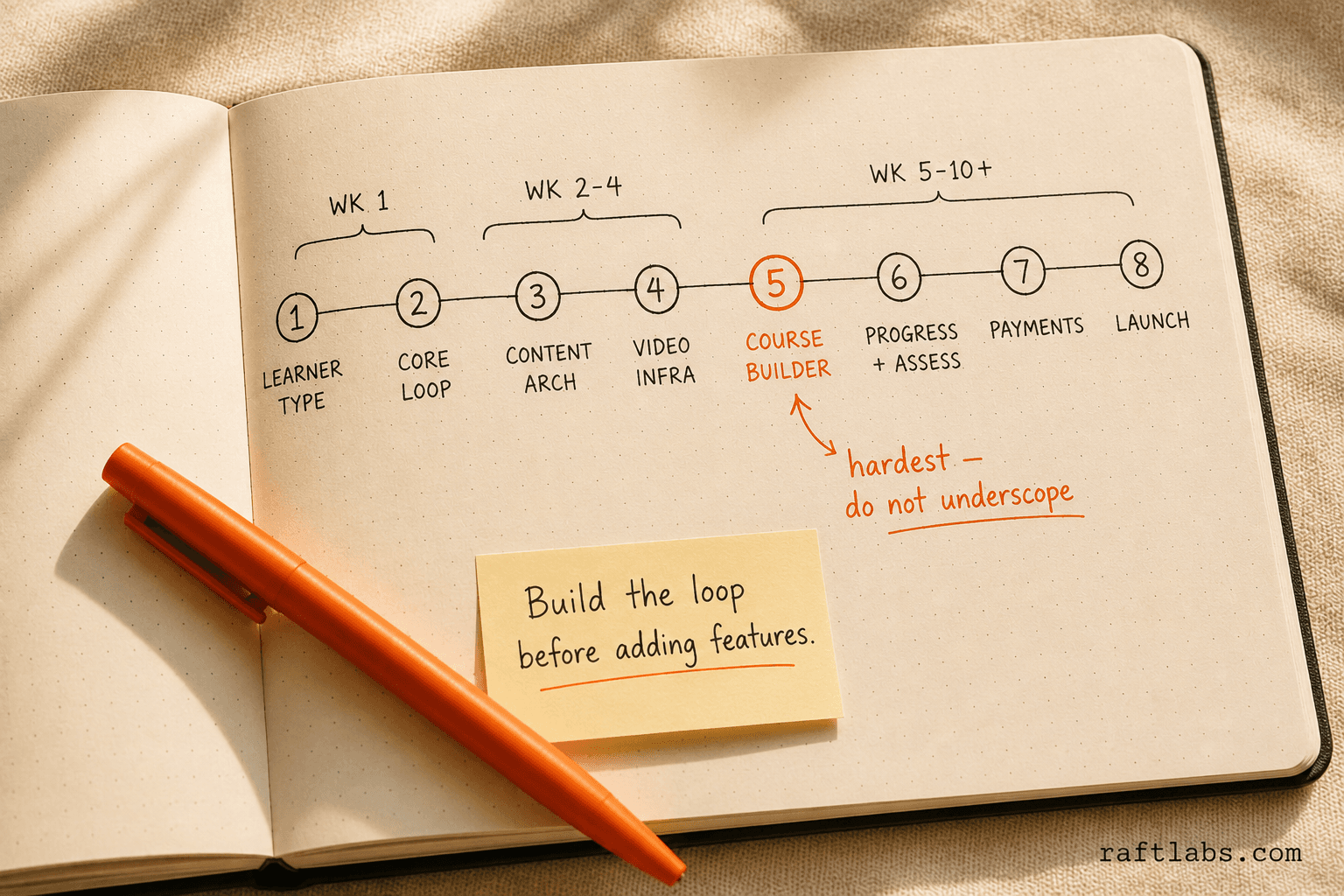

V1: The core loop ($25K-$60K | 8-10 weeks)
V1 has one job: get a learner from enrolled to certificate without friction. Everything in V1 serves that loop.
Course builder: Drag-and-drop lesson ordering, rich text and video upload, quiz builder, preview mode. This is the hardest component in the platform. It has more interaction states than any other element and consistently takes 30-50% longer than initial estimates.
Video hosting: Vimeo OTT for most builds. AWS S3 plus MediaConvert plus CloudFront for enterprise clients with data residency requirements. Never host video on your application server - buffering problems appear at 50 concurrent viewers and do not go away with server upgrades.
Progress tracking: Lesson completion events, quiz scores, overall course completion percentage. Track these from day one. You cannot improve what you do not measure.
Certificate generation: Auto-generated PDF on course completion. This is a learner expectation, not a V2 feature.
Payments and enrollment: Stripe for one-time purchases or subscriptions. If B2B, add bulk seat purchasing and team invitations.
What V1 does not include: gamification, AI features, cohort management, SCORM, SSO, advanced analytics. Those come after completion rate data tells you whether the core experience is working.
V2: B2B and organization management ($35K-$55K additional | 10-14 weeks)
V2 adds the organizational layer that corporate training programs need.
SSO integration (SAML or OIDC): Connects to your clients' identity providers. Required for any B2B sale into organizations with IT security requirements.
Multi-tenant organizations: Each client organization gets its own admin portal, scoped learner data, and branded experience. This is architecturally significant - build it right in V2 or pay heavily to retrofit it later.
HRIS integration: Automated provisioning from Workday, BambooHR, or ADP. New employees enter the right training tracks automatically. Existing off-boarding removes access.
Advanced analytics dashboard: Custom metric definitions, cohort completion comparisons, manager-level reporting, export to CSV or BI tools.
Team management: Manager dashboards, group enrollment, bulk assignments.
V3: Scale and engagement ($25K-$50K additional | 8-12 weeks)
V3 is for organizations where the core platform works and completion rates are established. Invest here only when you have data showing which features move the needle.
Gamification: Points, badges, leaderboard. Effective when learners compare themselves to peers. Build after you have cohort data.
SCORM compliance: Required for clients who need to host your content in Cornerstone, Workday Learning, or SAP SuccessFactors. Add when an enterprise deal requires it, not before.
Mobile apps (iOS and Android): Add $20K-$40K. Worth it when your usage data shows more than 30% of content is consumed on mobile.
AI features: Adaptive learning paths, automated quiz generation from content, AI-powered feedback on open-ended responses. These are V3 investments because they require training data from actual learner behavior to work well.
Where LMS projects fail
Most LMS development projects do not fail because of bad technology choices. They fail in two places.
The course builder is underscoped by half
The course builder - the tool content creators use to build courses - is almost always estimated as a single feature. It is not. It is five features that interact with each other: lesson ordering with saved progress state, rich text editing with media embeds, video upload with processing status, quiz builder with branching logic, and preview mode that exactly replicates the learner experience. Add drag-and-drop reordering across lesson types, empty state handling, partially-complete course editing, and stakeholder feedback cycles on the UX, and you have a component that consistently takes twice the estimated time.
The failure mode: teams ship the course builder at 70% fidelity, instructors encounter the limitations in production, and the platform gets labeled as "unfinished" before it reaches learners. The fix is to scope the course builder as its own workstream, not a single line item, and add 40% to whatever the initial estimate is.
Completion rate is never instrumented
An LMS where you cannot measure completion rate by course, by cohort, and by learning path is not a training platform. It is a video hosting service with a quiz attached. Organizations consistently deprioritize analytics in V1 to save budget, then discover six months post-launch that they cannot answer the question their board or their clients will eventually ask: is this working?
Completion rate analytics do not require a sophisticated BI stack. They require that every lesson completion, quiz attempt, and certificate generation fires a trackable event from day one. The cost of adding this in V1 is low. The cost of retrofitting it after learner data has been accumulating in an unstructured form is significant.
A McKinsey Global Institute analysis of corporate learning programs found that organizations with completion rate measurement built into their LMS were 2.4x more likely to report measurable improvement in workforce performance versus those without it.
How RaftLabs builds LMS platforms
Our LMS engagements start with two decisions made before any code is written: video infrastructure and whether SCORM is required in V1. These two choices determine more of the budget and timeline than any other technical decision, and they cannot be changed cheaply after build has started.
The first deliverable in every engagement is a content architecture document. It defines the course model (sections, lessons, content types), the learner data model (enrollment, progress events, completion states), and the video hosting integration. Stakeholders review and approve this document before development starts. Teams that skip this step and go straight to UI design consistently encounter database schema changes mid-build that cost more time than the architecture document would have taken.
We have shipped LMS platforms for corporate training programs, professional certification companies, and B2B SaaS onboarding workflows. The consistent finding across all of them: the organizations that define a completion rate target before build starts build better products. "Learners should be able to complete the course" is not a success metric. "80% of enrolled learners complete within 14 days of enrollment" is one. The difference in product decisions that follow from these two framings is significant.
Our typical LMS engagement runs 8-12 weeks at fixed scope. The scope is defined after a 30-minute call where we align on learner type, organizational model, video infrastructure, and whether SCORM is in scope for V1.
If you are evaluating whether custom LMS development is the right call for your organization, that 30-minute call is the right starting point. We will tell you directly if TalentLMS or a Moodle configuration would cover your requirements - custom development is not always the answer.
Ask an AI
Get an instant summary of this post from your preferred AI assistant.
Frequently asked questions
Straight answers to what buyers ask before they scope. Still stuck? .
- Custom LMS development costs $25K-$60K for an MVP covering course builder, video hosting, progress tracking, quiz, and certificate. A full B2B platform with SSO, team management, and analytics costs $60K-$100K. An enterprise LMS with SCORM compliance, white-labelling, and advanced reporting runs $100K-$150K+. The two biggest cost drivers are video infrastructure choice and whether SCORM compliance is required.
- Choose custom when your per-seat SaaS cost exceeds $2K/month, when you need white-labelling for resale, when enterprise clients require SCORM-compliant content, or when your workflow needs SSO integration with an HRIS. Moodle and TalentLMS are the right starting point for most teams; custom development is for organizations that have outgrown them.
- An MVP LMS takes 8-10 weeks. A B2B LMS with team management and analytics takes 12-16 weeks. An enterprise LMS with SCORM and SSO takes 16-22 weeks. Timeline is primarily driven by video infrastructure complexity: a standard Vimeo integration adds one week; custom AWS video processing with adaptive bitrate streaming adds three to four weeks.
- You need SCORM if enterprise clients must import your content into their existing LMS platforms such as Cornerstone, Workday Learning, or SAP SuccessFactors. You do not need SCORM if learners access your platform directly. Most consumer and SMB platforms skip SCORM in V1. SCORM adds $10K-$20K and three to four weeks to a build.
- A V1 LMS needs four things: a course builder for content upload and organization, video hosting with adaptive streaming, learner progress tracking with completion events, and assessment plus certificate generation. Everything else - gamification, cohort learning, AI tutoring, advanced analytics - comes after the core loop works and completion rate data tells you where to invest.
- Yes, but not by matching their feature set. Teachable and Kajabi have a decade of product investment behind their creator tools. The custom platforms that win are the ones that serve a specific audience better than a generic tool can: a corporate training team that needs HRIS integration, a professional association that needs CEU tracking, or an education company whose students install a branded app under their own name. Narrow the scope to what one buyer segment needs and the off-the-shelf platforms cannot compete on that ground.
